I have a test Advanced Roadmap I am working with in preparation for creating roadmaps for all of our teams. I have 3 test projects with pristine issues. I've set up 4 JAR Kanban "teams" each with a weekly capacity of 40 hours. I have monthly releases for 1 of the projects. (This is what we have in our company.)
I've experimented and arrived at a schedule. When I then add a new task, lowest priority, 40 days estimate and auto-schedule, the preview shows Team 4. Team 4 is booked in a higher priority slot above so this would overbook Team 4. If I continue on and Accept the changes, the new Epic is instead assigned to Team 1, and overbooks Team 1 instead. This sequence is shown in the attached screenshots, colored by Team.
In my experiments, I've had the auto-schedule shrink the time to less than the estimate, but it consistently overbooks a team. Am I doing this wrong or are these bugs?

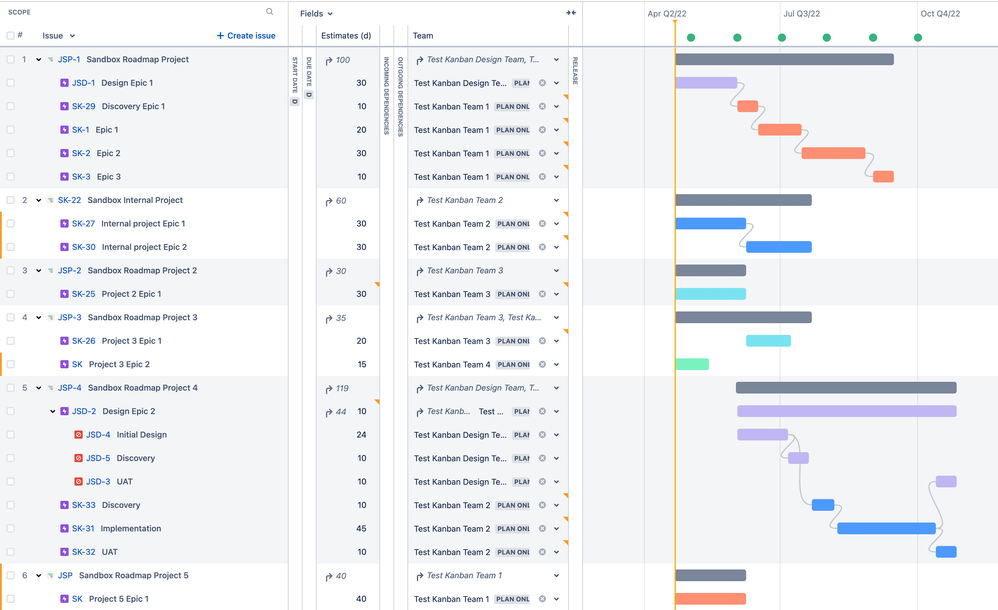

Added the new task. Preview shows Team 4:
Accepted changes, now assigned to Team 1:
This one with estimate of 50 days, overbooks Team 4 completely.
Online forums and learning are now in one easy-to-use experience.
By continuing, you accept the updated Community Terms of Use and acknowledge the Privacy Policy. Your public name, photo, and achievements may be publicly visible and available in search engines.
