I have a problem with Auto-Scheduler functionality.
Unfortunately, I cannot manage to set the schedule correctly and no matter how I change the options, the auto scheduler does not want to set two items together simultaneously.
I have configured teams (for testing purposes I have selected a team of 2 people whose shared resources are 80h per week).

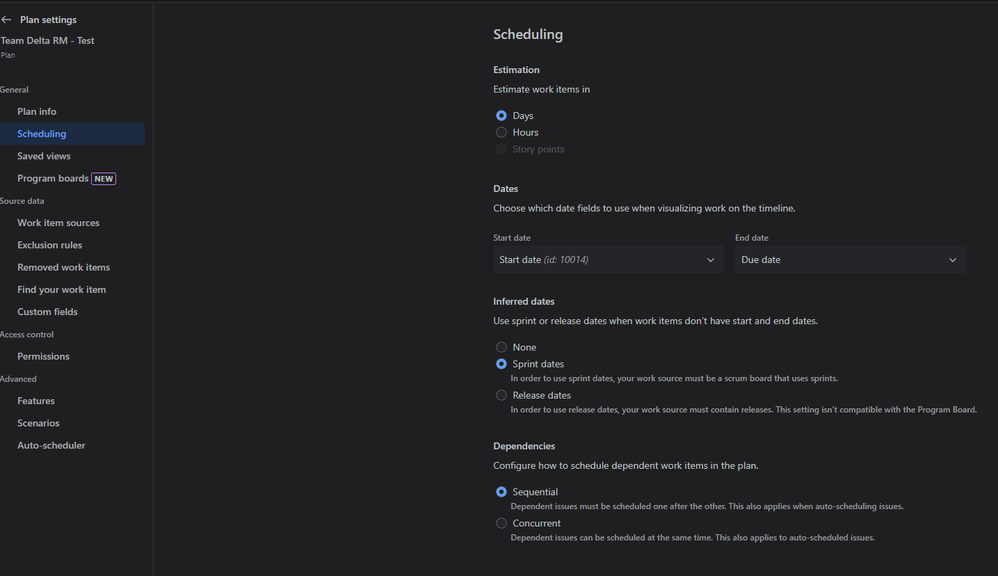

In addition, my plan is set to one that estimates tasks in days.
I select four tasks, assigned only to the team of these two people.

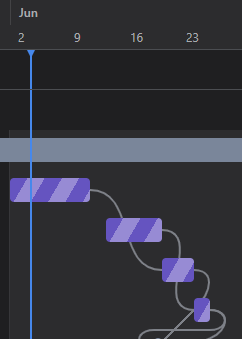

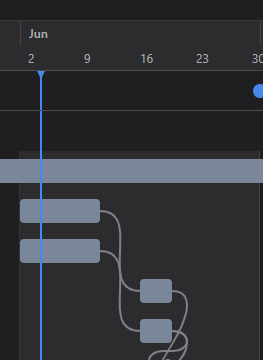

The tasks are appropriately marked and pinned to each other. They have filled in estimate times (10 days, 10 days, 4 days, 4 days). set by me manually)
And the auto scheduler loses Original Time Estimates and simultaneously work options.
Is something wrong with my settings? What should I do to make sure that the auto scheduler feature will distribute the work simultaneously?
This is just a test, the task that awaits me concerns a larger number of teams, dependencies and tasks and in order to complete it, it would be very useful for me to be able to use the option of automatic time setting adjusted to the resources at our disposal.
