Dependency management in Jira Align handles a couple of scenarios which are listed below.
Dependency between

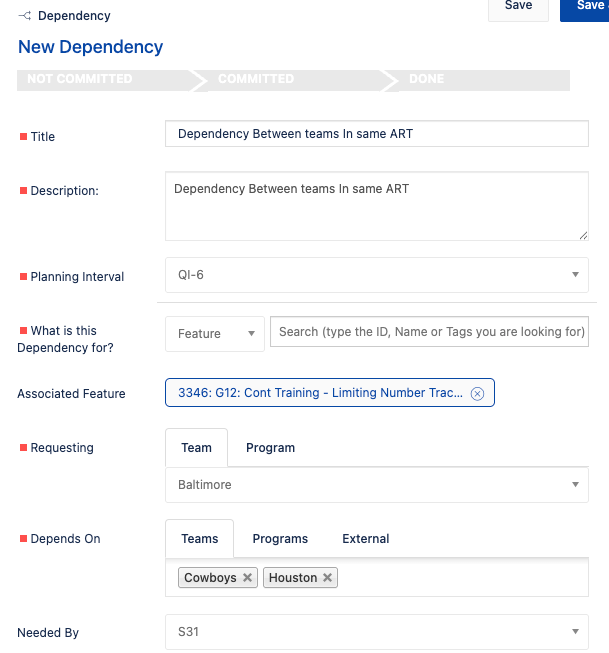

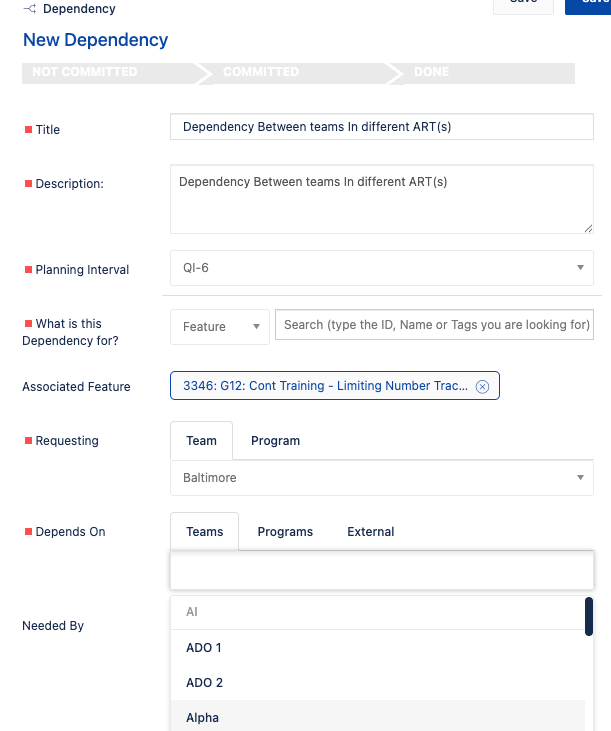

Teams within an ART(Agile Release Train)/Program

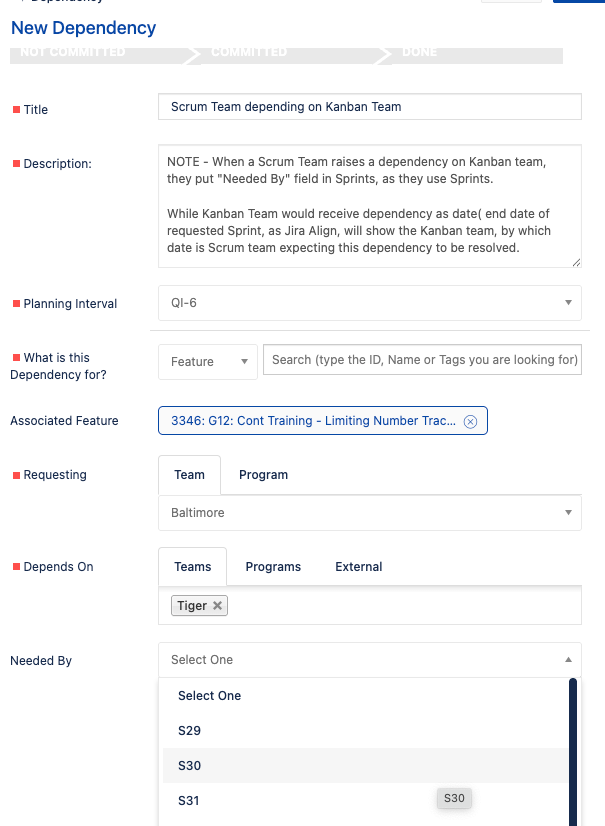

Scrum Team depending on Kanban Team within/different ARTs

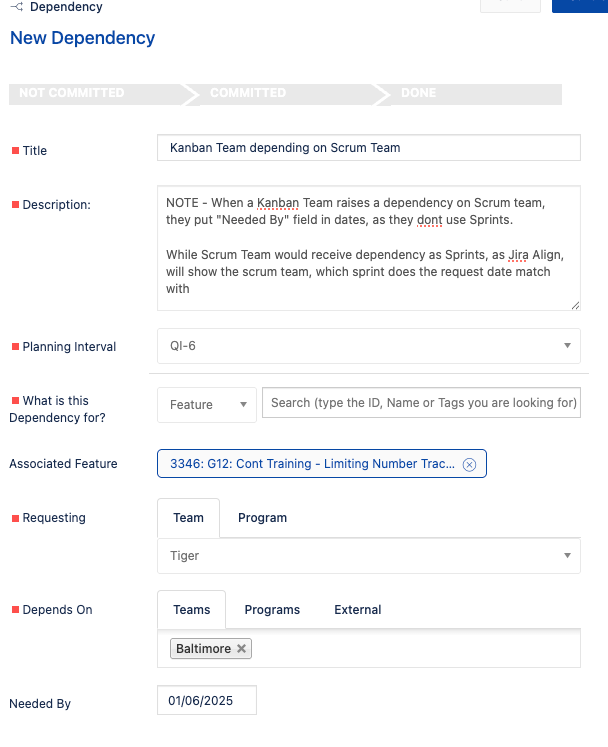

Kanban Team depending on Scrum Team within/different ARTs

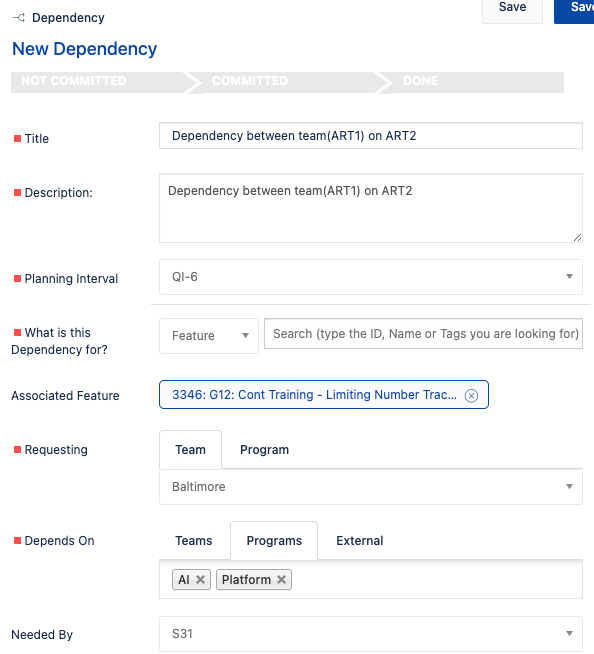

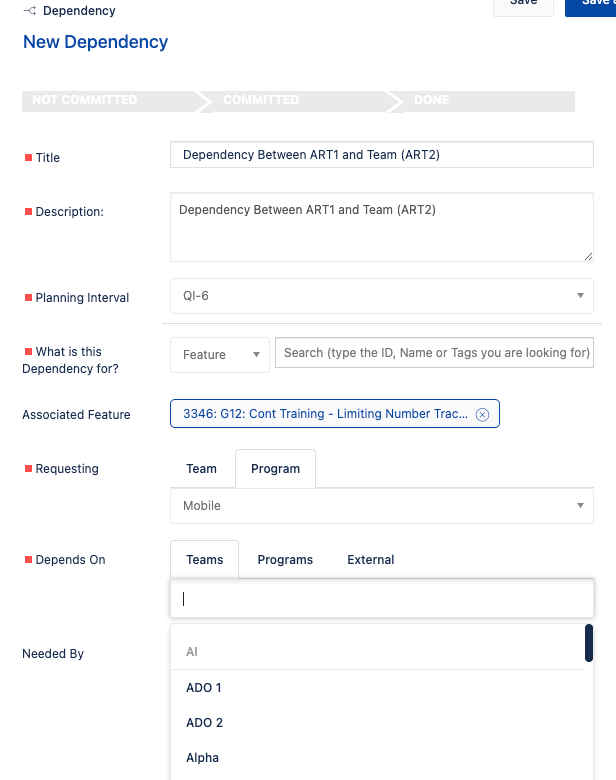

Team(ART1) and ART2

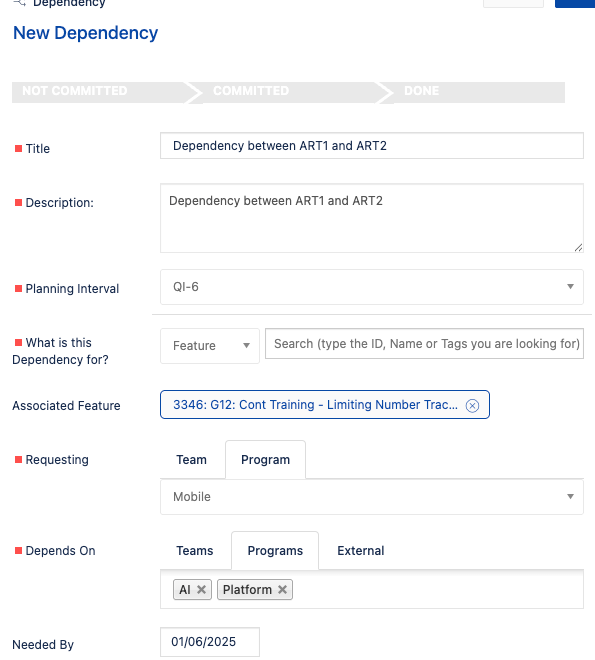

2 ARTs

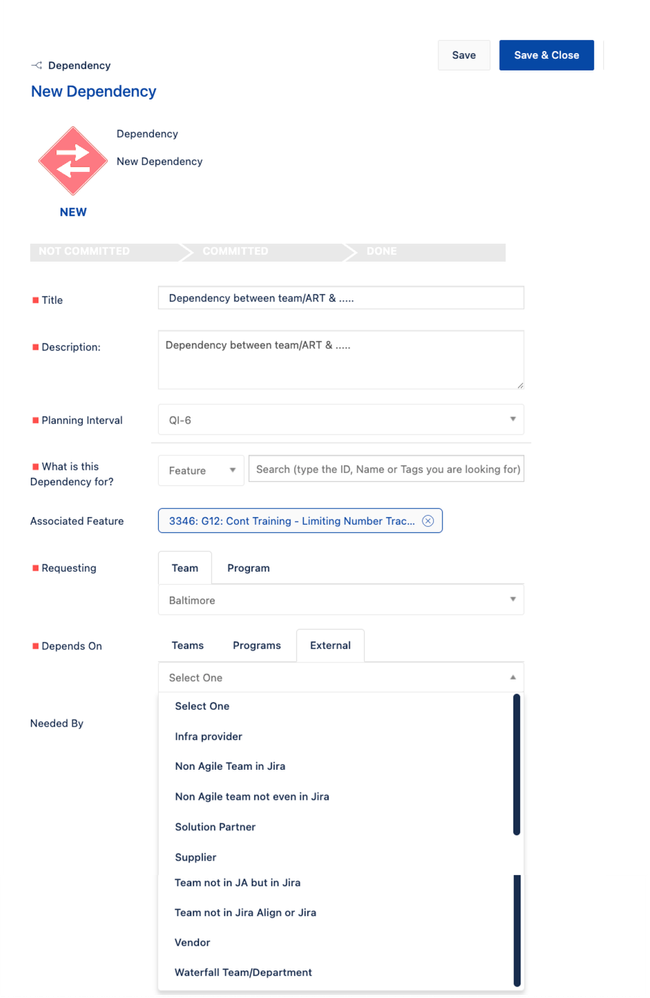

Team/ART on External Entities like
Team not in JA
Team/Department not in Jira ( say Finance, HR..)
Team working in Scrum
Team working in Kanban
Team not working in Agile
Team not part of an organisation ( say a vendor/supplier)
All this can be visualized in Jira Align in one place.
Dependency Lifecycle(Happy Flow)

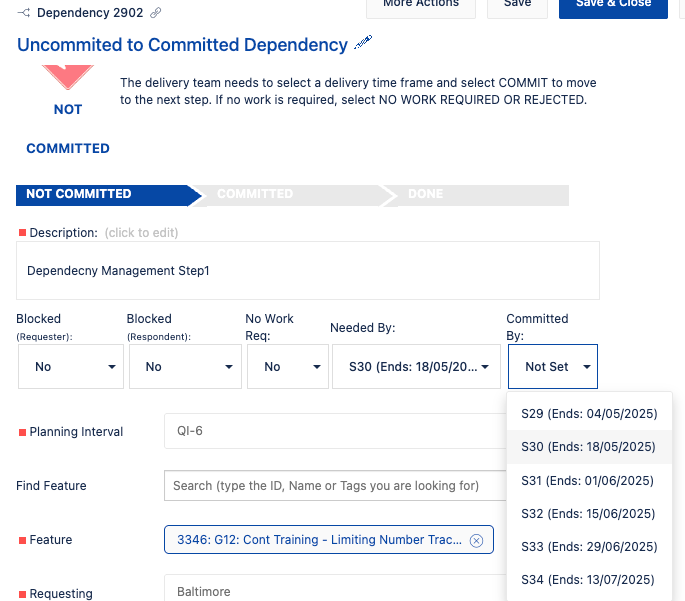

Step1 - Dependency is raised between 2 parties(requestor and respondent).

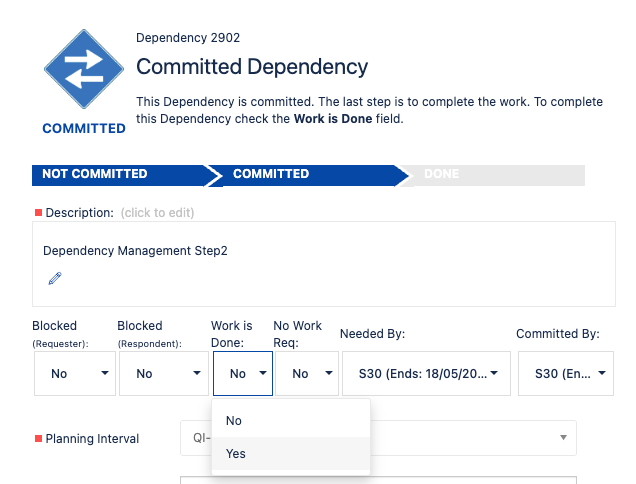

Step2 - Respondent confirms back to requestor on time proposition.

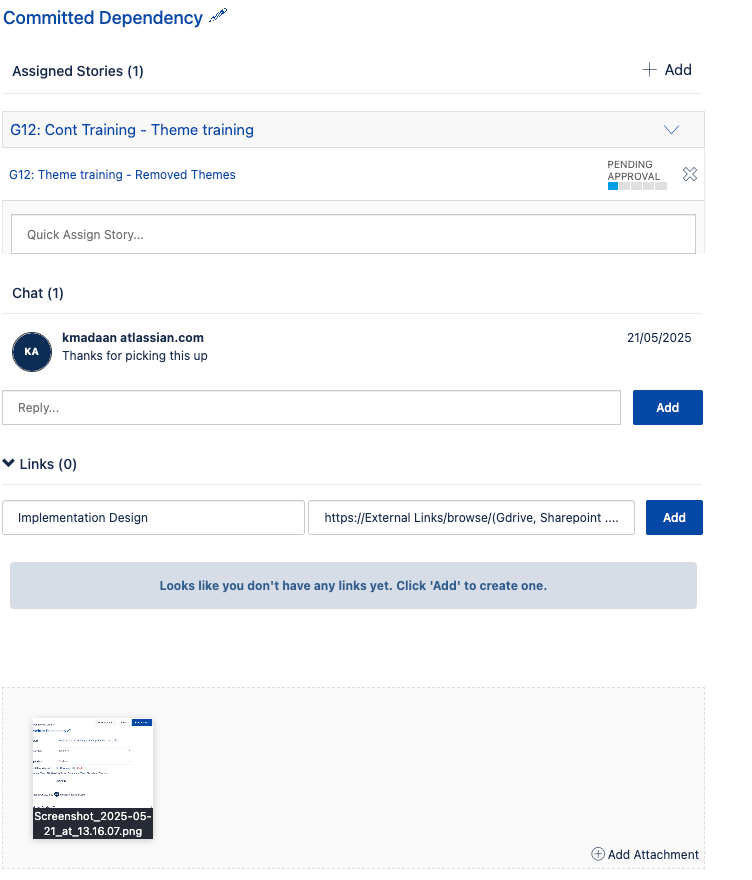

Step3 - Respondent can add work items via which the respondent team is going to resolve the dependency.
Step4 - Requestor and respondent can chat with each other regarding the dependency, add additional information links, also attachements
Step5 - Respondent confirms dependency has been sorted.

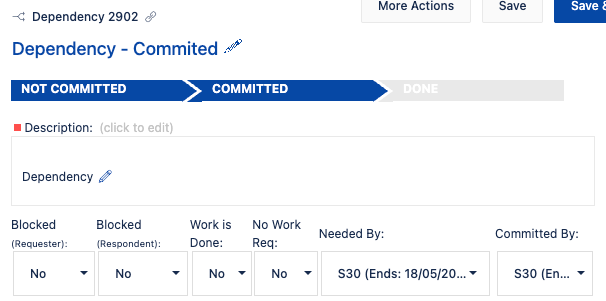

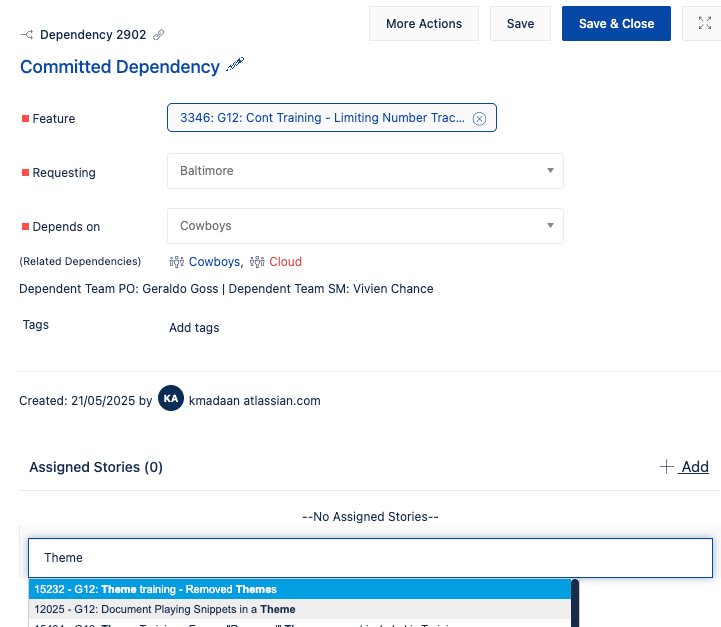

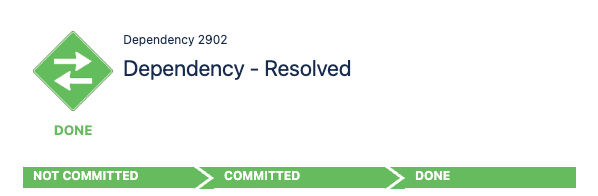

Step6- Dependency appears as resolved.
Karan Madaan
Senior Enterprise Solution Strategist
2 accepted answers
0 comments
