Hi,
i want to compare the estimated duration of my task with the remaining Days in my active sprint and give a warning, if there are not enough days left, to solve the Task.
My Problem: I don't know how to get the value of the remaining Days.
this is my Code. I hope someone can tell me the correct name for my placeholder "Sprintremaintime",
----
with diff = (Sprintremaintime - Estimated_Duration):
IF diff < 0:
""":panel[Warnung]{backgroundColor=red color=white}"""
ELSE:
""":panel[Okay]{backgroundColor=green color=white}"""
----
Best Regards,
Uwe
Seems to be a bigger Problem for the most people. ;-)
I found a solution, that works for me:
Today is Tuesday. My Testsprint-Ending is set to Friday. Here is my code:
----
with sprintzeit = DAYS_BETWEEN(NOW(), MAX(sprint.enddate)):
with diff = (sprintzeit - estimated_duration + 1):
If issueType != Epic:(
IF diff > 2 :
""":panel[$diff]{backgroundColor=green color=white}"""
Else If diff > 0:
""":panel[$diff]{backgroundColor=orange color=white}"""
Else:
""":panel[$diff]{backgroundColor=red color=white}""")
----

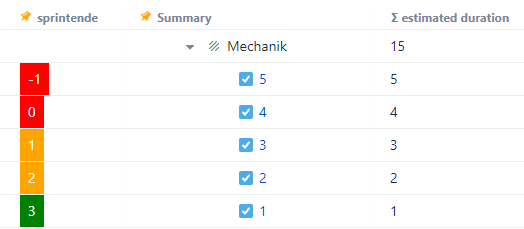

and this is what i want to see (just the left days of my tasks):
