Hello,
from my point of view, a milestone in a project is a zero-day "task" which labels an important event in the project. I am migrating my project from MS project where the duration of a milestone is explicitly set to a duration of zero. If I link another task to this milestone, it starts immediately the day the milestone is reached.

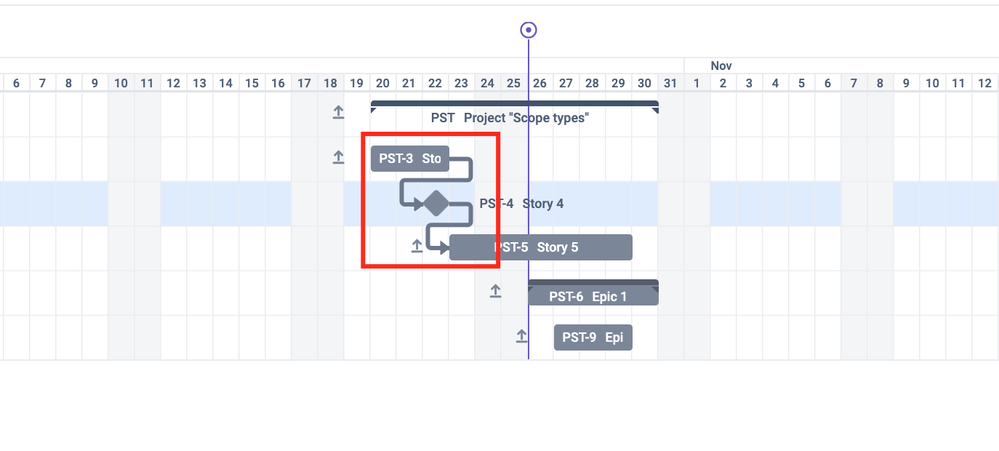

However, if I define a task in BigGantt to be a milestone, it causes 1-day delays for all linked tasks (see the attached image). As if the milestone itself has a duration of one day.
Are milestones in BigGantt supposed to be designed like this? I do not see a feature in this.
@Hi @Eric Ruider
Yes, at the moment, milestone by default is taking 1 day. However, we fully understand the validity of your request. We are constantly developing our tool, and this functionality is on our Product Roadmap.
Have a look at the feature request: ONE-21250. Please follow the ticket to be up to date with the functionality progress. Please note that it is best to open the link in the incognito tab of your browser.

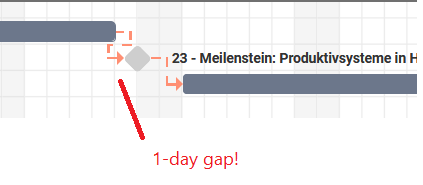

Meanwhile, you can use the workaround. Please click on the link; when popup will be displayed, enter the value for “Lag time” -1. You will preserve the ASAP mode link, and a milestone will not delay other tasks in the project. See my image as a reference.
And here is the result:
Best regards,
Anna
SoftwarePlant Support
Online forums and learning are now in one easy-to-use experience.
By continuing, you accept the updated Community Terms of Use and acknowledge the Privacy Policy. Your public name, photo, and achievements may be publicly visible and available in search engines.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
