Identify Work Items Added to a Sprint — Why It Matters (and How to Harness the Signal)

The short of it

Added work inside a sprint isn’t a failure — it’s a signal. If we don’t intentionally identify and explain what was added (and what we traded off to make room), three things happen: 1) our metrics lie, 2) planning confidence erodes, and 3) stakeholders learn the wrong lesson about predictability. The goal isn’t bureaucracy; it’s clear learning loops and healthier flow.

What exactly counts as “added work”

  • Added: Any work item introduced into an active sprint after the sprint starts (e.g., urgent bug, small enabler, scope split that appears as a new ticket, a regulatory fix).
  • Not counted as added: Re-estimating an in-sprint item without changing its acceptance criteria; splitting an item where the children replace the parent without increasing scope and remain clearly linked.

Rule of thumb: if the issue history shows the Sprint field was set to the current sprint after it started, it’s an addition worth logging.

Why added work matters (more than it seems)

1) Predictability and planning confidence

Velocity and throughput mean little if we inject scope mid-sprint. Identifying added work lets you:

  • Separate planned vs. unplanned work in your reporting.
  • Quantify the interrupt load (incidents, compliance requests, and ad-hoc requests).
  • Forecast with honest inputs rather than wishful historical velocity.

2) Stakeholder trust

A short “additions recap” during Reviews builds credibility. When stakeholders see the why (e.g., Sev‑1, regulatory deadline), they understand trade‑offs instead of concluding the team “can’t plan.”

3) Focus, quality, and flow

Unfenced additions create context switching, increase cycle time, and lead to more defects. Clear policies about what qualifies for mid‑sprint entry protect quality without slowing critical fixes.

4) Product learning & demand hygiene

Additions reveal how work actually arrives: incidents, executive asks, dependencies becoming available, or weak refinement upstream. Each tag you capture points to a process improvement.

Guardrail: If added scope rate (points added after start ÷ points originally committed) consistently exceeds ~10–15% across 3+ sprints, you have an intake/refinement or demand‑management problem to solve.

Simple, trustworthy metrics (added‑only)

  • Interrupt Load %
    Unplanned points added after start ÷ total points completed
    How much of your sprint was consumed by interrupts?
  • Added Scope Rate
    Points added after start ÷ points originally committed
    How big were the additions relative to the plan?
  • Added vs. Planned Cycle Time
    Compare median cycle time of items added after start to planned items.
    If added items are always slower or starve review/QA, your expedite lane isn’t truly expedited.
  • Additions per Week & Concentration
    Count new items per week and who they land on.
    Repeatedly routing to one person is a burnout risk.

Qualitative tags (keep it light)

Use one‑word labels when logging an addition: Incident, Regulatory, Customer, Dependency, Discovery, Quality, Exec. Patterns jump out in retros.

Tip: Prefer a burnup chart to visualize additions: the scope line rises when work is added, while the “done” line shows progress. Burndown alone often hides what actually happened.

Practical how‑to

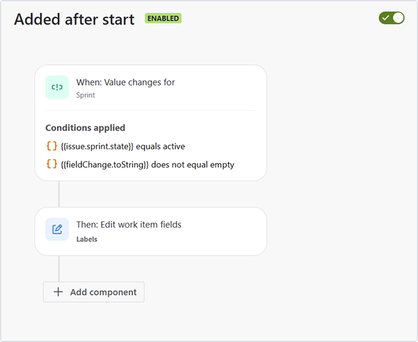

Jira Global Automation Rule

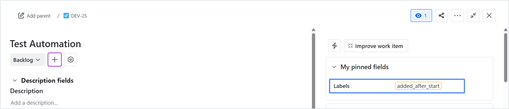

To make additions easy to query later via JQL, set a global automation rule (Jira settings → SystemAutomation) and restrict it to the necessary projects.image 1 (2).png

Group 1 (13).png

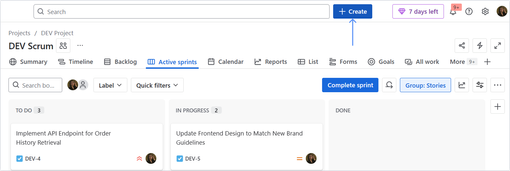

Important: This rule fires when the Sprint field changes. So, create tasks via the Create button in the header and then add them to the sprint. That way, the rule will apply the added label, and you’ll be able to filter with JQL reliably.

Group 2 (11).png

Handy JQL examples:

  • Current sprint additions: sprint in openSprints() AND labels = added
  • Specific sprint additions: sprint = 149 AND labels = added
  • Recently added items across teams: labels = added AND updated >= -14d

Jira Sprint Report (asterisk *)

You can spot tasks added after sprint start in the native Sprint Report — Jira marks such items with an asterisk (*) in the list. This is the simplest way to confirm additions during a Review or Retro and keep everyone aligned on what changed and why.

Group 4 (11).png

How to analyze additions in Time in Status by SaaSJet

Time in Status Report — basics

The Time in Status report calculates how long each issue spends in each workflow status (accumulated time). For additional analysis:

  • Add the “Created” column to the report and compare it to the sprint start date.
  • Sort by Created (descending) to quickly see items created after the sprint began.
  • If an issue’s Created date is later than the sprint start, it’s very likely an added item.

Group 6 (6).png

Pivot Reports

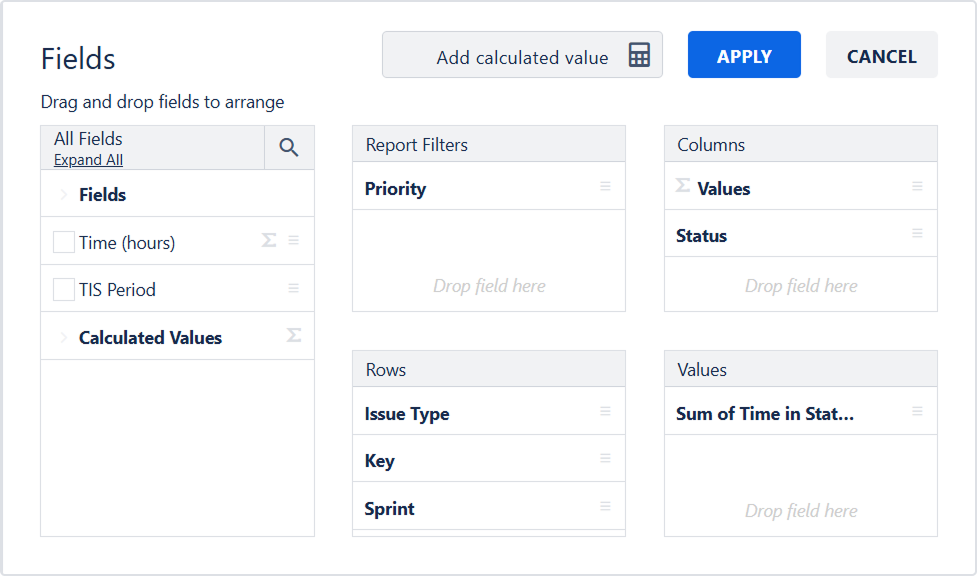

Let’s configure a pivot to understand impact:

  • Rows: Issue Type, Key, Sprint
  • Columns: Status
  • Values: Sum of Time (Hours)

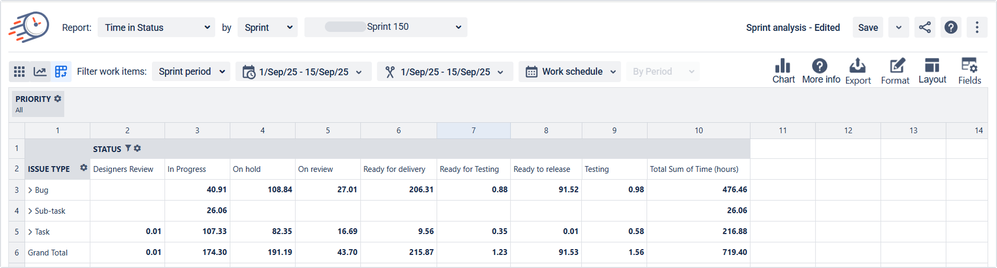

image 11 (1).png

What you get:

  • A per‑sprint view of all work included in that sprint, plus the time spent in each status.
  • Expanding a specific issue shows which sprints it lived in and how long it spent in different statuses.

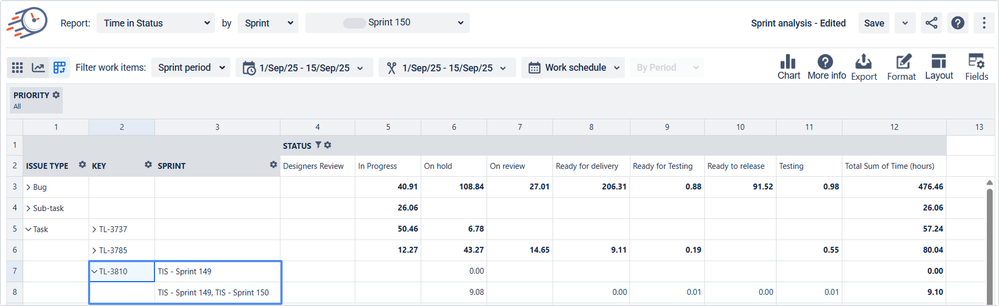

Group 11 (3).png

Example insight: Issue TL‑3810 shows in Sprint 149 only a short time in Hold, then moves to Sprint 150. This pattern (brief touch, then carry‑over) often indicates premature pull‑in; treat it as a refinement or dependency signal.

Group 12 (3).png

Variant to isolate additions:

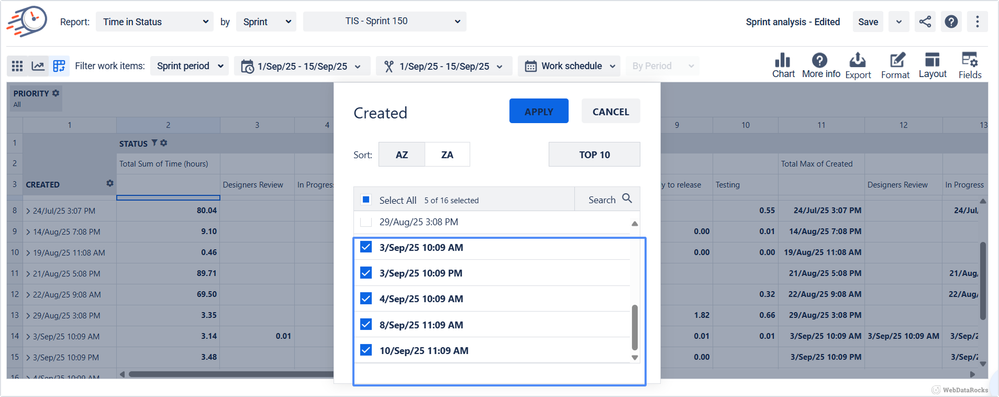

Add Row: Created and use a filter for dates after the sprint start. This isolates issues likely added mid‑sprint (or lets you exclude them if you want a view of planned‑only work).Group 13 (2).png

Group 14 (1).png

Sprint Report in the Time in Status app

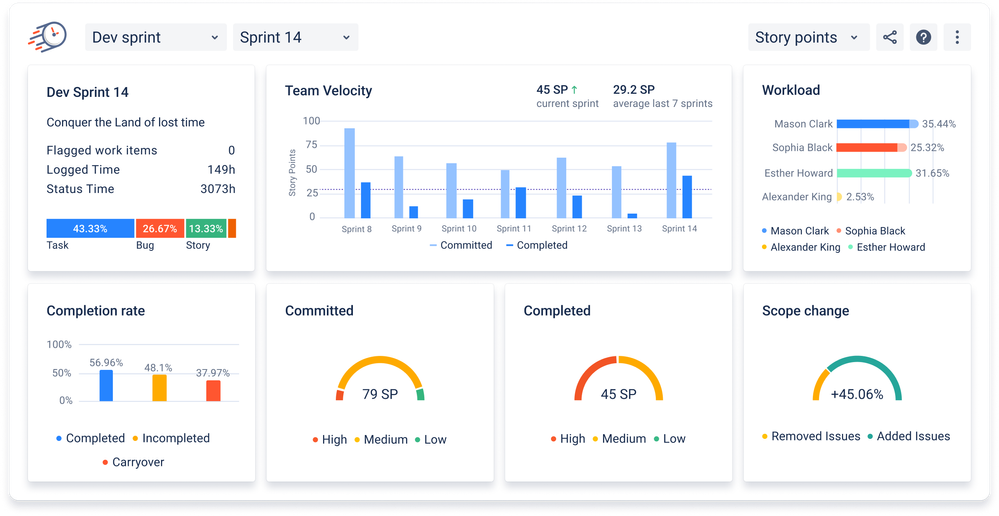

The sprint‑level report is great for a high‑level read of team performance in the sprint. While it doesn’t list the exact issues added/removed, the Scope Change and Completion Rate sections let you analyze the percentage impact of additions on outcomes. Use this view alongside the labels = added list for a complete story in Reviews.

Frame 624636 (8).png

Gentle recommendation: If you’re already in Jira, Time in Status by SaaSJet surfaces these patterns without building custom reports. Start with the “Time in Status” and “Assignee Time” reports filtered to items added after sprint start; pair them with the labels = added JQL to keep the narrative crisp.

Minimal process that actually helps

  1. Sprint Addition Policy (one paragraph):
    “We accept in‑sprint additions for incidents, compliance, and small, high‑leverage enablers. PO + Tech Lead must approve. We cap additions at ~10–15% of capacity. Every addition gets a tag and one‑line reason.”
  2. Addition Log (lightweight):
    Maintain a tiny table (board or doc). Capture: Ticket, Date, Reason Tag, Owner, Impact (1 sentence). (Template below.)
  3. Daily signal:
    If a ticket was added in the last 24 hours, call it out in standup: what changed, why, and what are we deprioritizing?
  4. Review recap:
    One‑slide “Additions This Sprint” with totals (+points added) and 2–3 bullets of why. Transparency beats perfect plans.
  5. Retro focus:
    If Added Scope Rate > ~15% or Interrupt Load > ~20% for 2–3 sprints, pick one improvement: better intake triage, stricter DoR, a small expedite buffer, tighter dependency management, or smaller stories.

Lightweight templates

A) Sprint Additions Log (copy/paste)

Ticket

Date

Reason Tag

Owner

Impact (1 sentence)

TKT‑123

2025‑10‑05

Incident

Alex

Sev‑1; replaced homepage cache; moved non‑critical refactor to backlog

TKT‑145

2025‑10‑06

Dependency

Maya

Partner API opened; created 1‑day enabler

B) Slack update (≤90 seconds)

Heads‑up: we added TKT‑123 (incident) and TKT‑145 (dependency). +6 points added (~12% of capacity). We deferred the settings polish to protect QA. Summary is in the sprint doc.

C) Retro prompt

  • What % of our capacity went to added work? Is that sustainable?
  • Which tags repeat (incident, dependency, exec)? How can we reduce these at the source?
  • Did we protect code review/QA from expedite overload?
  • Are additions concentrated on a few people?

Common anti‑patterns (and better moves)

  • “Everything is urgent.”
    Better: Cap additions; force a clear deprioritization when adding.
  • Sneaking in big, unrefined work.
    Better: Time‑box a spike/enabler; keep additions small and reversible.
  • Hero routing.
    Better: Rotate on‑call/expedite ownership; use Assignee Time to detect overload.
  • Hiding the additions.
    Better: Burnup + additions log; numbers become a conversation, not a scoreboard.

Final take

Tracking what we add isn’t about policing the team — it’s about protecting focus, telling the truth about predictability, and turning surprises into structured learning. Keep the process small, make the math honest, and use tools that surface flow signals quickly. If you want a no‑fuss way to see the real impact of mid‑sprint additions, try Time in Status by SaaSJet on your next sprint and compare added vs. planned items in your review.
