if it is possible to leave Start date and End date empty if you have a BigPicture program "linked" with your Jira project?
Yes, of course, Jira will let you save a task with the 'Start date' and 'End date' fields empty.
Now, what effect will it have on what you see in BigPicture? It much depends on what you had set here: Jira administration > Manage apps > BigPicture > Technical configuration > General > Task > Task configuration
With the commonly seen configuration, evident in Fig. 1, the BigPicture Gantt chart, for instance, will show a newly created task with Start and End dates empty as a very "narrow", only one-day-long bar.
On the other hand, if you had made the setting shown in Figure 2 (-- Not Synchronized --), then if you leave Start and End dates empty on a task then it will have no effect on the bar on the Gantt chart; BP will expect you set the bar length "manually", by dragging&dropping it.
Still on Fig. 2, note that you can make this Start/End date setting per each project, separately.
More scenarios are discussed here: https://wiki.softwareplant.com/display/DOCUMENTATION/Task+configuration#Taskconfiguration-TaskPeriodConfiguration

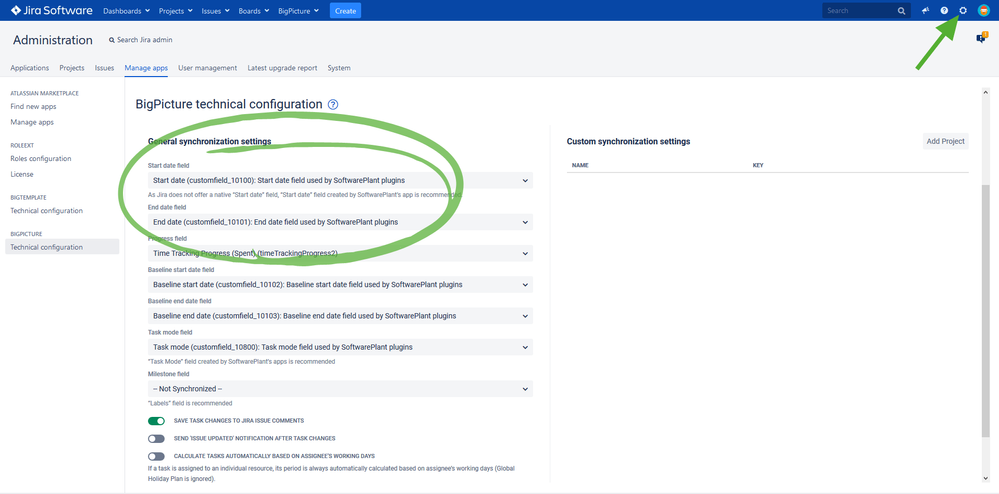

Figure 1

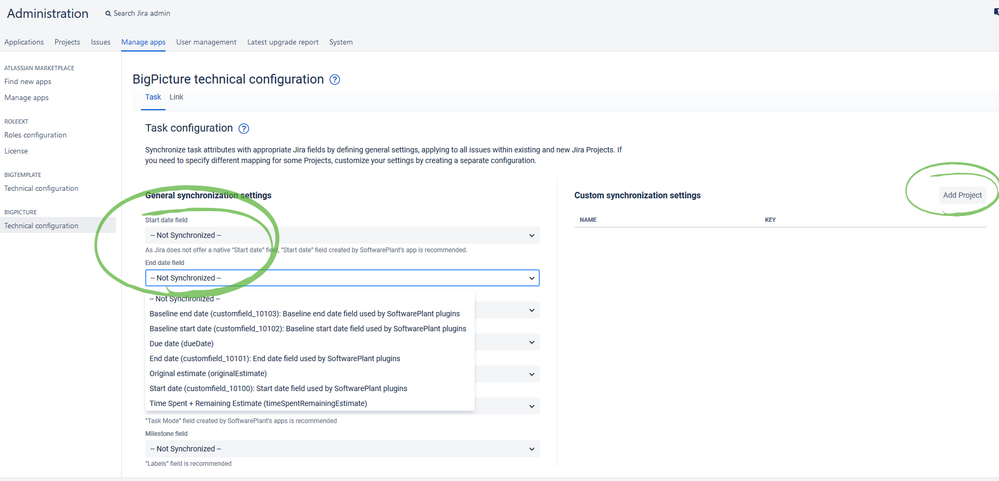

Figure 2
Online forums and learning are now in one easy-to-use experience.
By continuing, you accept the updated Community Terms of Use and acknowledge the Privacy Policy. Your public name, photo, and achievements may be publicly visible and available in search engines.
You must be a registered user to add a comment. If you've already registered, sign in. Otherwise, register and sign in.
